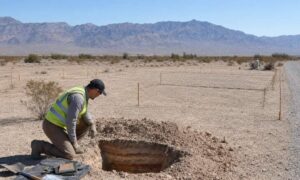

Percolation Test Layout for Rural Home Sites
Building a rural home takes more than picking a spot for the house. You also need to plan for the septic system, the well, and the driveway. All of these share the same lot. If you get the layout wrong early, you may have to redesign the whole site later. Here’s how to plan a percolation test layout that holds up once the house, well, and driveway go in.
Place the Percolation Test Envelope Before Fixing the House Footprint
Don’t pick the house spot first and then try to fit the septic system around it. Nevada rules say the test holes must sit inside the proposed soil absorption area. This means the house, the septic tank, the drainfield, and the test holes need to be planned together. Work this out on paper before anyone starts digging.
If the house moves after the test is done, the approved absorption area may no longer match the new plan. That can mean new test holes. It can also mean a new engineered report and a delay on your permit. A better way is to sketch the house, the septic area, and the reserve area together from day one. Then adjust the house spot on paper, not after the ground has been broken.
Draw the Well Protection Area Into the First Site Sketch
The well matters just as much as the house. Nevada septic rules set distances that must separate wells from sewage system parts. These distances can change based on how the well was built and the site conditions. This rule applies to your own well. It also applies to wells on nearby lots.
Mark every well on your first site sketch, not your final one. This means existing wells and any planned wells. In Pahrump, lots often sit close together. A well next door can limit where your septic area can go. Work this out before you pick a house spot. This can stop you from finding out too late that your septic area and a neighbor’s well don’t leave enough room.
Keep Driveway Traffic Outside the Future Absorption Zone
Driveways, parking pads, gates, and construction access all need a path across the lot. That path must avoid the septic area. Nevada rules do not allow sewage systems in any spot exposed to vehicle traffic or paving. The weight of vehicles packs down the soil. It can also damage buried system parts.
Plan your driveway route at the same time you plan the septic area, not after. This includes the route builders will use during construction. Heavy equipment can pack down soil in the absorption area even before the house is done. If the driveway and the drainfield overlap on paper, move one of them now. It’s much easier to move a driveway on paper than to move one after gravel and pipes are already in the ground.
Preserve a Second Buildable Area for Future Septic Replacement
Every rural home site needs two absorption areas planned, not just one. The primary area handles the system now. A reserve area must also stay open. This reserve area must be at least as big as the primary one. It’s there in case the first system ever needs to be replaced.
The reserve area follows the same rules as the primary one. It must stay unpaved. It must meet the same setback rules. It must stay clear of vehicle traffic. It’s easy to skip this step when a lot feels small. But skipping it can leave a homeowner with no legal spot for a new system if the old one fails years later. Set the reserve area aside on the plot plan from the start. Treat it as off-limits for anything else.
Check Whether Tomorrow’s Improvements Still Fit the Lot
A lot that works for the house and septic system today might not work later. A workshop, garage, patio, pool, or home addition can change things. Before you finish the layout, think through what future changes might look like on the property. Even ones that are years away matter now.
Look at where a shop or other structure might go. Then check if that spot conflicts with the primary or reserve absorption area. Do the same for patios, pools, and any planned additions to the house. Also check property line setbacks. A structure that fits inside the septic layout might still sit too close to the property line. Working through these choices now, while the layout is still on paper, keeps future buildings from running into a septic system that has to stay put.
